Introduction
A maintenance team drowning in spreadsheets. A plant manager who can't answer "what's our PM compliance rate?" without a week of digging. Multiple sites running different processes, none of them talking to each other.
A CMMS software RFP turns those pain points into one structured document—maintenance needs, operational gaps, and business goals—that every finalist answers the same way.
But a strong RFP is more than a feature checklist. Unclear scope, missing stakeholder input, weak integration requirements, and price-only comparisons routinely lead to a poor-fit system.
Inaccurate requirements gathering was cited as a leading cause of project failure in 37% of projects, according to PMI's Pulse of the Profession research.
This guide walks through deciding whether an RFP is the right tool, preparing requirements, writing the document, comparing proposals, and avoiding the mistakes that derail CMMS procurement.
Key Takeaways
- Connect maintenance pain points to measurable outcomes, not just list preferred features
- Involve maintenance, operations, IT, finance, procurement, and compliance before finalizing requirements
- Separate must-have, should-have, and nice-to-have items so vendors respond clearly
- Request comparable data on functionality, integrations, implementation, support, security, and total cost of ownership
- Validate every vendor claim through demonstrations, references, and proof-of-concept testing
How to Write a CMMS Software RFP

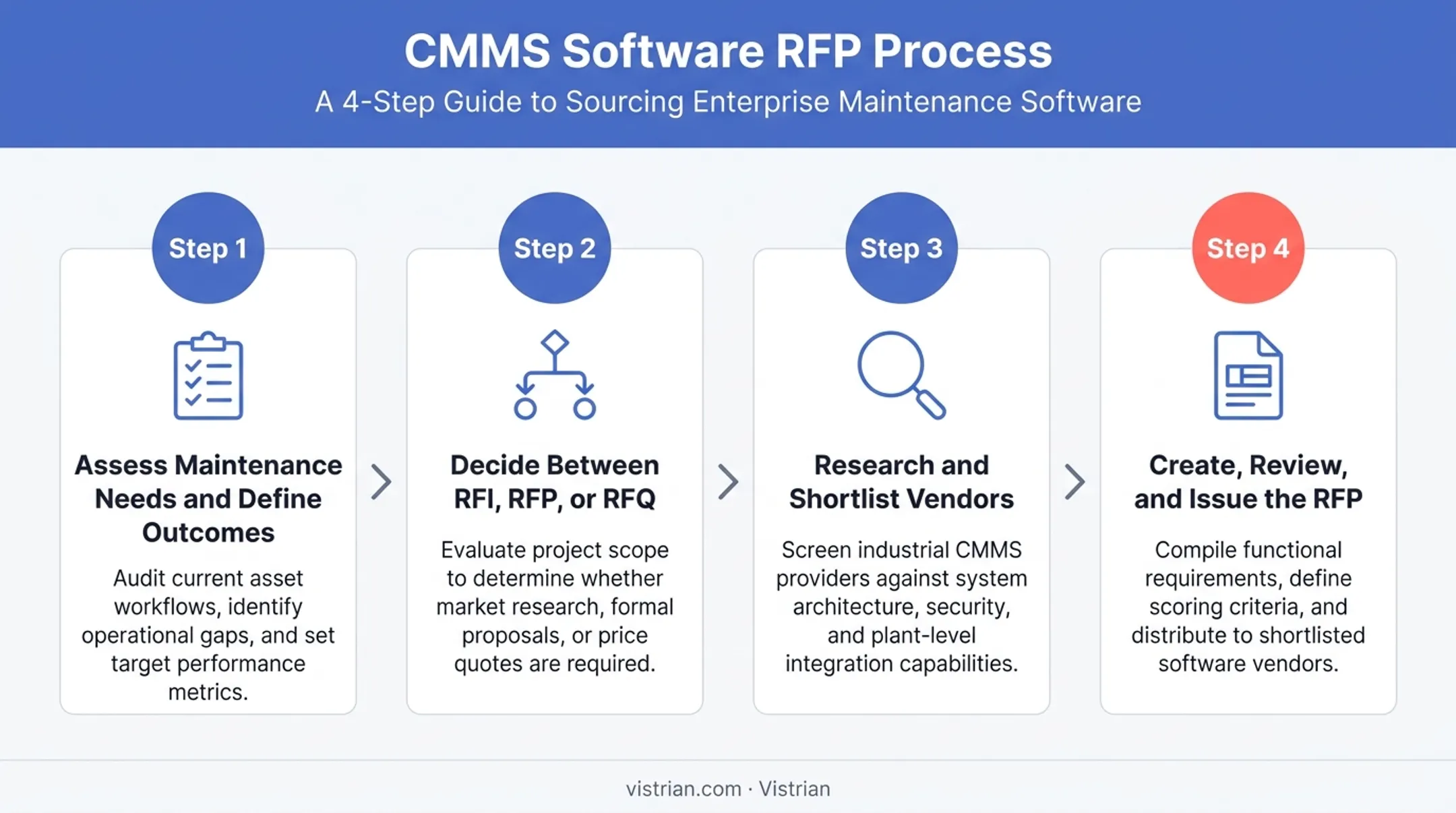

Step 1: Assess Maintenance Needs and Define Desired Outcomes
Start by documenting your current maintenance process: work requests, work orders, preventive maintenance, asset records, spare parts, reporting, and approval workflows. Write down what actually happens, not what's supposed to happen.
Then talk to the people who live in that process:
- Technicians and planners: surface daily process gaps
- Supervisors and operations leaders: need visibility and accountability
- IT: owns infrastructure and security requirements
- Finance and procurement: own budget and contract constraints
- Compliance: needs auditability and reliable recordkeeping
Translate every complaint into an outcome a vendor can address. "We can't find work order history" becomes "improved auditability and searchable maintenance records." "PMs slip constantly" becomes "improved preventive-maintenance execution and compliance tracking."
Pull whatever baseline data you actually have: backlog size, downtime hours, emergency work percentage, PM compliance rate, labor hours, and inventory discrepancies. Don't invent targets you can't support.
If the data doesn't exist yet, say so in the RFP and ask vendors how their reporting would help you start capturing it.
Step 2: Decide Whether an RFI, RFP, or RFQ Is the Right Document
Not every purchase needs a full RFP. According to the General Services Administration, an RFI is used to gather information when the market isn't well understood, an RFQ is used when scope and specifications are already defined and pricing is the main variable, and an RFP is used when you're seeking a complete solution to a problem you've defined but not fully solved.
Use an RFI first if:
- You don't understand the CMMS market yet
- Your vendor pool is too large to evaluate directly
Use an RFP when:
- You have complex integrations across ERP, MES, or SCADA systems
- You're rolling out across multiple sites
- You operate in a regulated environment
- The investment is significant and involves many stakeholders
Use an RFQ when:
- Scope and technical specifications are already locked
- Pricing, terms, and delivery are the main decision variables
Step 3: Research and Shortlist Vendors
Define screening criteria before you start looking at vendors, not after. Common criteria include industry experience, asset and site complexity handled, deployment model (cloud vs. on-premises), mobile access, integration capabilities, security posture, implementation resources, and customer references.
For each capability that matters to you, ask vendors to specify whether it's standard, configurable, custom-developed, dependent on a third-party tool, or unavailable. This single question eliminates most vague sales-pitch answers early.
Build a shortlist large enough for a fair comparison, typically 3 to 6 vendors, but small enough to manage demos, scoring, and reference checks without burning out your evaluation team.

Step 4: Create, Review, and Issue the RFP
Organize the document into clearly labeled sections and provide a response template or requirements matrix so every vendor answers the same questions in the same format. That consistency is what makes side-by-side comparison possible.
Before distribution:
- Assign one procurement contact for all vendor communication
- Establish a written Q&A process with published deadlines
- Distribute clarifications equally so no vendor gets an answer another doesn't
- Route the draft for internal review through legal, IT/security, finance, maintenance leadership, and the executive sponsor before you issue it
Request proposals in a consistent format: executive summary, requirement responses, implementation plan, assumptions, pricing, references, risks, and exceptions.
When to Use a CMMS RFP and What to Prepare First
A formal RFP adds structure and accountability, but it's overkill for a small, urgent, single-site purchase with straightforward requirements. Use one when:
- Maintenance workflows are complex or span multiple facilities
- Legacy systems require integration planning
- Regulatory obligations demand documented evaluation
- The commitment is long-term and expensive
- Several stakeholder groups need to sign off
If needs are standard, the vendor landscape is already familiar, or you need to deploy fast, a lighter process: demos, trials, references, and a requirements checklist often gets you there faster without sacrificing rigor.
Organization and Operating Context
Give vendors enough context to propose accurately: facility count and type, asset types, maintenance team size, user groups, current systems, deployment locations, and expected growth. Skip the company history — vendors need operating context, not a brand story.
Data, System, and Implementation Readiness
Inventory what needs migrating: assets, locations, equipment hierarchy, PM plans, parts, vendors, work history, documents, and user records. Then document your existing landscape:
- ERP, MES, SCADA, or BMS systems requiring integration
- Identity, sensor, or reporting tools that need to exchange data
- Required integration method, data owner, and exchange frequency
Confirm internally who owns each implementation role. Vendors can't plan around resources you haven't committed:
- Data cleansing
- Testing
- Training
- Change management
- Ongoing administration
RFP Requirements and Evaluation Parameters
The strongest RFPs specify the business result, operating context, evidence required, and priority level. They skip dictating every screen or workflow. Dictating the interface just narrows your vendor pool without improving fit.
Project Scope, Objectives, and Success Criteria
Define scope by site, asset group, user role, process, and deployment phase. Is this one plant, several plants, or an enterprise rollout? Ask vendors to explain how their solution supports:
- Asset hierarchies and work requests/orders
- Preventive maintenance and inspections
- Labor tracking and parts inventory
- Approvals, contractor management, and maintenance history Include measurable acceptance criteria, but be honest about what's vendor-verifiable now versus what needs your own baseline data first.
Functional and Technical Requirements
Separate functional requirements (what the system does) from technical requirements (how it's built and secured). For each item, require a structured response: fully available, configurable, custom, third-party, roadmap, or not available. Cover the essentials:
- Mobile technician access and offline/low-connectivity workflows
- Role-based permissions, audit trails, attachments, notifications
- Dashboards, reporting, search, export, configurable forms
- Cloud or on-premises deployment, hosting location, backup/recovery, uptime commitments
- Authentication, encryption, security testing, and compliance documentation Require vendors to substantiate security claims with actual documentation: SOC 2 reports or ISO/IEC 27001 certification, not marketing language. For manufacturing environments, ask specifically how the system handles:
- Production equipment and downtime events
- Meter readings and sensor data
- Legacy controllers
- Multi-plant comparisons
Integration, Data Migration, and Scalability
Require a proposed integration approach covering APIs, standard protocols, databases, files, webhooks, or middleware, along with who's responsible for what, dependencies, costs, and support boundaries. Ask vendors to walk through data-mapping, cleansing, validation, deduplication, trial migration, cutover, and rollback plans. Historical work-order records matter for audits and trend analysis, so protect them during cutover. Manufacturers should push hardest on how maintenance software connects to the plant floor. VistrianMMS, for example, integrates with FactoryLOOK for machine and sensor data and with Vistrian's Analytics platform for condition-based and predictive maintenance. Those are capabilities worth probing even if you evaluate another vendor. Any CMMS RFP for manufacturing should ask how preventive maintenance, work orders, asset data, analytics, and legacy equipment connectivity work together, rather than assuming they will integrate later. Also confirm the platform scales across users, assets, sites, and data volume without creating new data silos as you add IIoT or analytics initiatives down the road.
Implementation, Support, Pricing, and Evaluation
Request a phased implementation plan: discovery, configuration, integrations, data migration, testing, training, launch, stabilization, and post-launch optimization. Ask vendors to name:
- Implementation roles and your team's responsibilities
- Training formats and support channels
- Response targets, escalation paths, and SLA commitments
- Product roadmap practices and customer success ownership Require itemized pricing covering licenses, users, sites, implementation, migration, integrations, training, support, upgrades, storage, and renewal terms. Evaluate total cost of ownership, not the sticker price. Gartner's TCO guidance notes that focusing on unit price alone can increase total costs by hiding lifecycle expenses. Build a weighted scoring rubric across:

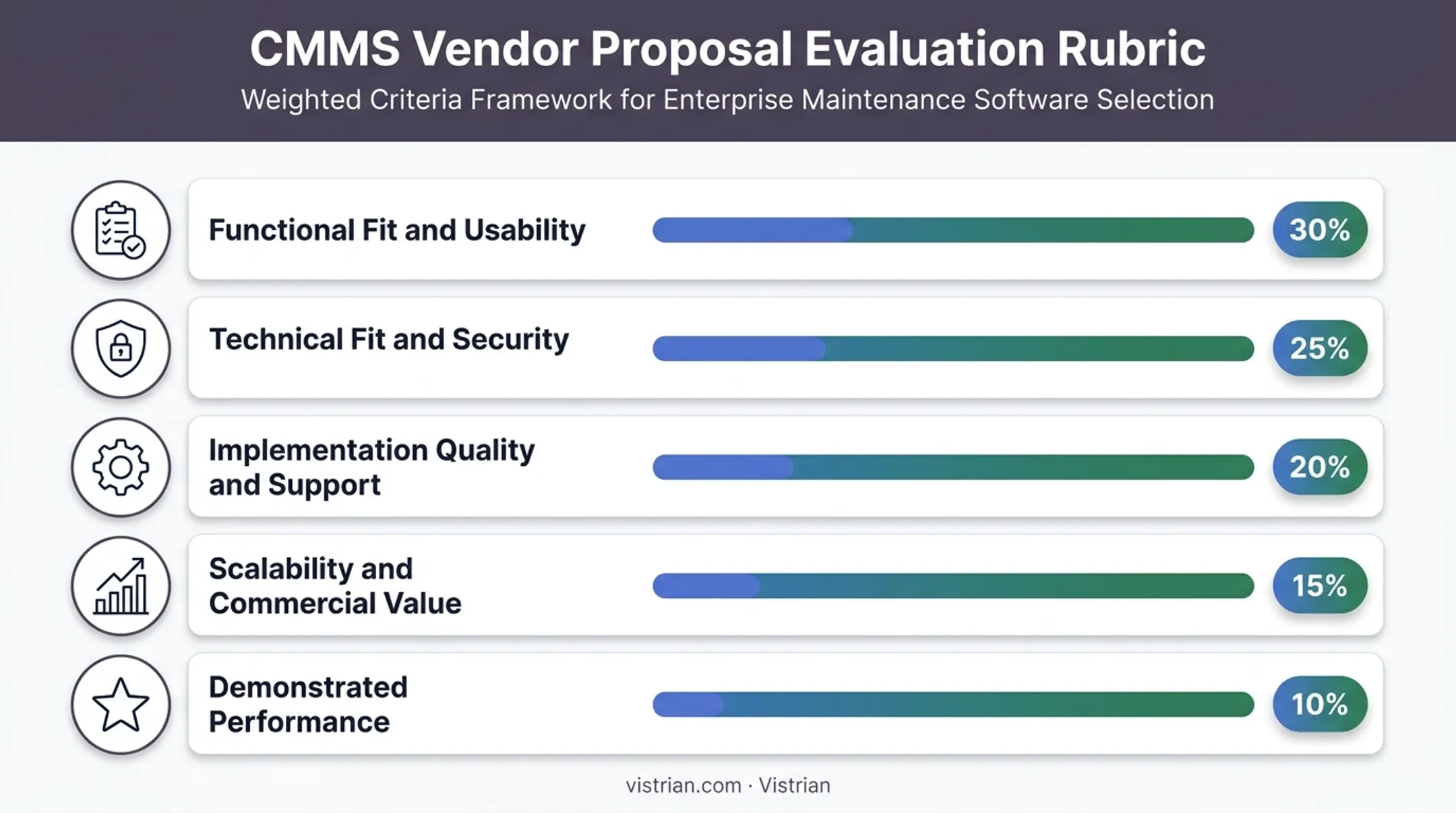

- Functional fit and usability
- Technical fit and security
- Implementation quality and support
- Scalability and commercial value
- Demonstrated performance Then validate scores with scripted demos using realistic maintenance scenarios, sandbox testing, and reference calls with organizations of comparable size and complexity.

Common Mistakes, Troubleshooting, and Alternatives
Most RFP problems start before proposals ever arrive — unclear goals, incomplete context, untestable requirements, or an evaluation process driven by gut feel instead of evidence.
Common Mistakes to Avoid
- Copying a generic feature checklist without process context, user roles, asset types, business reasons, priorities, or required evidence
- Overspecifying the solution by prescribing interfaces or designs when outcomes are what matter
- Omitting critical details such as user volumes, sites, asset counts, integrations, data migration, security, or exit terms
- Letting price dominate when a low subscription quote may exclude implementation, integration, training, or migration
Troubleshoot Weak or Inconsistent Vendor Responses
When responses are weak or inconsistent, tighten the process:
- Vague answers: Convert broad questions into structured fields — yes/no with explanations, required evidence, use-case demos, and explicit assumptions
- Conflicting interpretations: Issue one clarification to every participant and require resubmission in the same format
- Customization or roadmap-only fits: Document delivery risk, ownership, cost, timeline, and contractual remedy in writing
- Score disputes: Return to documented priorities and retest the capability with the same scripted scenario for every finalist
Alternatives to a Formal RFP
A full RFP isn't always necessary:
- RFI plus targeted demos when you need market education before writing detailed requirements
- Checklist, trial, and references for smaller implementations with standard workflows
- Direct negotiation or RFQ when scope is clear and a vendor already looks like a strong fit
Even without a full RFP, keep written requirements, evaluation notes, pricing assumptions, security findings, and approval records. You'll need them if the decision is ever questioned.
Conclusion
Writing a CMMS RFP works best when you start with actual maintenance problems and desired outcomes, then translate them into prioritized, testable requirements. Stakeholder alignment, integration planning, transparent scoring, and total-cost analysis matter more than a long feature list ever will.
Compare solutions against your real workflows—and where your operation is headed, not only where it is today. If you need maintenance management plus real-time equipment visibility and analytics, evaluate whether VistrianMMS and Vistrian’s modular smart manufacturing suite match that broader requirement.
Frequently Asked Questions
How is CMMS different from ERP (like SAP) or CRM software?
A CMMS focuses on maintenance workflows, assets, work orders, preventive maintenance, and equipment history. An ERP manages broader enterprise resources, while a CRM manages customer relationships. Integrations often let these systems exchange financial, inventory, or production data.
What is a CMMS software RFP?
It's a structured request that communicates maintenance, technical, implementation, commercial, and evaluation requirements so vendors can submit comparable proposals. It replaces informal sales conversations with a documented, side-by-side comparison.
When should an organization write a CMMS RFP?
Write one for complex or multi-site operations, major system integrations, regulated procurement, significant investments, or purchases involving multiple stakeholder groups. Skip it for simple, single-site, low-complexity purchases.
What should be included in a CMMS RFP?
Include organization context, objectives, scope, functional and technical requirements, integrations, data migration, security, implementation, support, pricing, timelines, submission rules, and evaluation criteria.
How many CMMS vendors should receive an RFP?
Aim for a manageable shortlist based on initial research and fit — typically 3 to 6 vendors. Enough for fair comparison, few enough to avoid overwhelming your evaluation team.
How should CMMS RFP responses be evaluated?
Use a pre-defined weighted rubric alongside a structured response matrix, scripted demonstrations, proof-of-concept testing, reference checks, security review, and total-cost analysis. Score consistently across every finalist using the same scenarios.
