Introduction
A critical pump seal fails at 2 a.m. The technician heads to the storeroom, but the part isn't where the system says it should be. Or worse, it was never logged in the first place.
The line stays down while someone drives to a supplier or improvises a fix that won't hold.
This scenario plays out in plants every week. Maintenance inventory management is the coordinated process of identifying, purchasing, storing, issuing, tracking, and replenishing the parts and supplies that keep equipment and facilities running.
This article breaks the discipline into practical steps: categorizing MRO inventory, setting control levels, connecting parts to assets and work orders, digitizing records where it makes sense, and measuring whether any of it is working.
Key Takeaways
- Balance spare stock against availability, cost, criticality, lead time, and storage space
- Accurate records and locations matter as much as having enough stock on hand
- Link inventory data to preventive maintenance, work orders, and purchasing to cut stockouts and excess
- A CMMS can automate visibility and replenishment, but solid processes have to come first
What Maintenance Inventory Management Includes
Maintenance inventory, sometimes called MRO inventory (maintenance, repair, and operations), is different from the inventory a business tracks for production. Raw materials and finished goods move toward a sale. MRO items exist purely to keep assets running, not to become part of a shipped product.
Common MRO Categories
Most storerooms hold a mix of:
- Critical spare parts — items that stop production if unavailable
- Repairable or rotating components — motors, pumps, gearboxes sent out for rebuild rather than scrapped
- Consumables — filters, gaskets, fasteners, cleaning supplies
- Tools — both shared shop tools and calibrated instruments
- Lubricants and fluids — oils, greases, coolants, and hydraulic fluids
- Safety supplies — PPE, lockout/tagout devices
- Preventive maintenance materials — belts, bearings, and kits tied to scheduled tasks

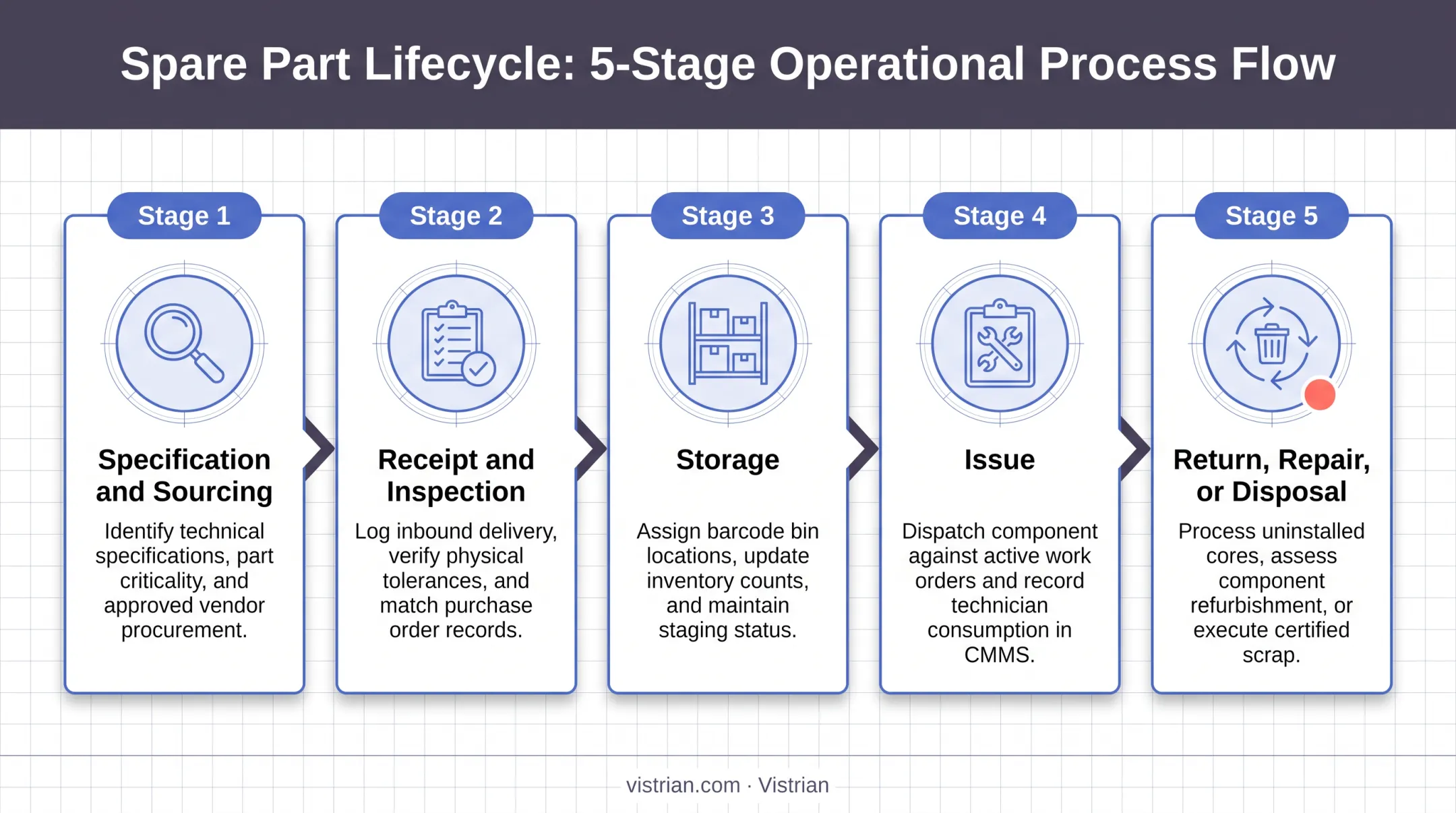

The Inventory Lifecycle
A part's journey through your operation typically runs through these stages:
- Specification and sourcing — defining the exact part and approved suppliers
- Receipt and inspection — verifying quantity and condition against the purchase order
- Storage — labeling and placing the part in its designated location
- Issue — releasing it against a work order
- Return, repair, or disposal — depending on whether the item is reusable, repairable, or scrap

What to Track for Every Part
At minimum, each item record should capture:
- Standardized part number and description
- OEM reference and unit of measure
- Compatible asset and criticality rating
- Supplier and lead time
- Storage location and quantity on hand
Some plants manage this on spreadsheets. Others use dedicated inventory tools, a CMMS, an EAM system, or an integrated manufacturing platform. The right choice depends on part count, site count, and how tightly you need inventory data tied to work orders and asset history.
Why Maintenance Inventory Management Matters
Poor inventory control doesn't just create inconvenience. It creates measurable operational damage.
- Stockouts delay work orders, extend downtime, and push technicians toward rushed buying or unsafe temporary fixes
- Overstocking ties up working capital in parts that deteriorate, go obsolete, or duplicate stock already in another bin
- Bad locations or vague descriptions waste search time—a part you can't find in ten minutes is as good as missing
The National Institute of Standards and Technology estimates that total annual US manufacturing maintenance costs and losses average $222.0 billion, with downtime alone accounting for roughly $18.1 billion of that figure.
Reliable parts availability also enables the shift from reactive to planned maintenance. When a bearing or filter is on the shelf, preventive schedules hold. When a sensor raises a condition-based alert, the right part is already staged.
Vistrian's Maintenance Suite ties spares availability to preventive schedules and failure alerts so teams can act before a breakdown forces their hand.
Build a Maintenance Inventory Management Framework
Fixing inventory chaos starts with a clear structure, not a new software purchase.
Establish Your Baseline and Standards
Before setting policies, count what you actually have:
- Physically count existing stock and reconcile it against records
- Flag duplicate, unidentified, or unlabeled items
- Document every storage location
- Separate usable, damaged, expired, obsolete, and quarantined parts
Once the baseline is clean, build a standardized item master. Every entry should include:
- Consistent naming and part numbers
- Units of measure and manufacturer references
- Compatible equipment
- Bin or storeroom location
Barcode or QR labels make receiving, issuing, and cycle counting faster and less error-prone.
Prioritize and Set Stock Policies

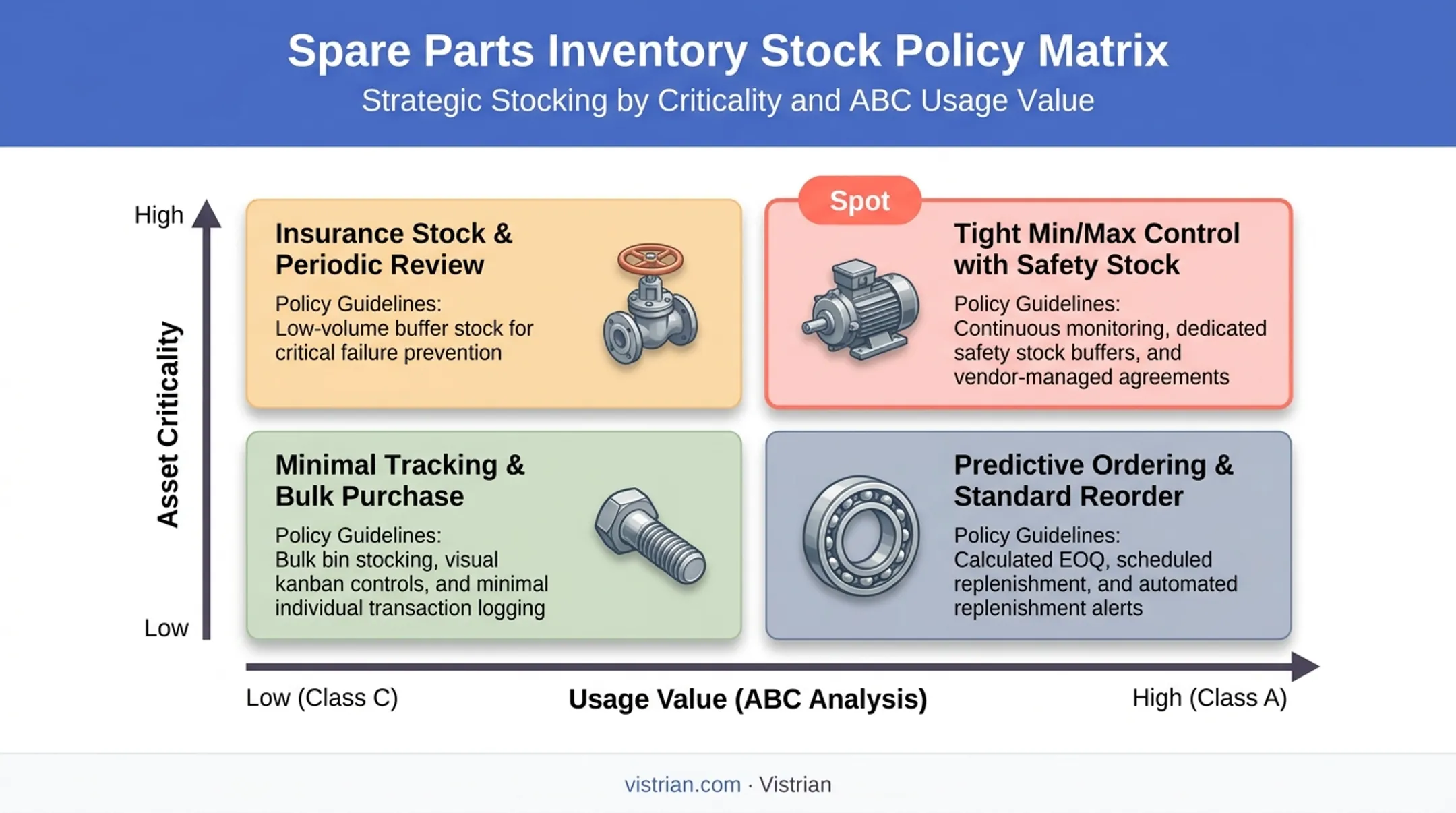

Not every part deserves the same level of control. Combine ABC analysis (ranking by value and usage) with asset criticality to decide how tightly you manage each item.
A $12 sensor that halts an entire line if missing deserves more attention than a $500 part with three backup units elsewhere in the plant. Cost alone doesn't determine criticality — impact does.
For each priority tier, set:
- Minimum and maximum stock levels
- Reorder points and safety stock
- Economic order quantity, where usage is predictable
- Supplier minimum order quantities

Lead-time variability should push reorder thresholds higher for parts with long or unreliable supply chains, even if usage is low.
Handle Special Cases and Multi-Site Scaling
General stock rules break down for parts that need traceability or a different lifecycle. Give these their own handling paths:
- Repairable spares
- Serialized components
- Lot-controlled items
- Defective returns
Link every issue and return to the relevant asset or work order so consumption patterns show up by equipment—not just by storeroom.
For multi-plant operations, standardize the framework, naming conventions, categories, and policies across sites. Let each plant set its own stock levels based on local supplier lead times and usage.
Implement the Process With People, Systems, and Data
A framework only works if someone owns each piece of it.
Assign Ownership and Build a Repeatable Workflow
Name clear owners for each inventory function:
- Purchasing and receiving
- Storage and issuing
- Cycle counts
- Master-data maintenance
- Obsolete-stock decisions Then map the storeroom workflow end to end:
- Purchase request and approval
- PO, receipt verification, and inspection
- Labeling and put-away
- Controlled issue, return, and reconciliation High-value, safety-critical, or serialized parts need access controls and a documented chain of custody. Those same controls support ongoing accuracy work. Replace the once-a-year full count with risk-based cycle counting. Count high-value, high-criticality, and frequently discrepant items more often; count low-risk consumables less.
Choose the Right System for Your Scale
Spreadsheets can work for a single site with a few hundred SKUs and low complexity. Beyond that, the manual reconciliation burden grows fast. Vistrian's Maintenance Suite—VistrianMMS for work orders and VistrianSMS for spares—ties work orders, asset records, spare parts, and usage history into one workflow:
- Tracks parts from receipt through consumption
- Follows high-value items by life, usage, location, and value
- Connects to legacy controllers alongside newer IIoT assets Software alone doesn't fix weak processes. A clean item master and defined workflow have to exist first.

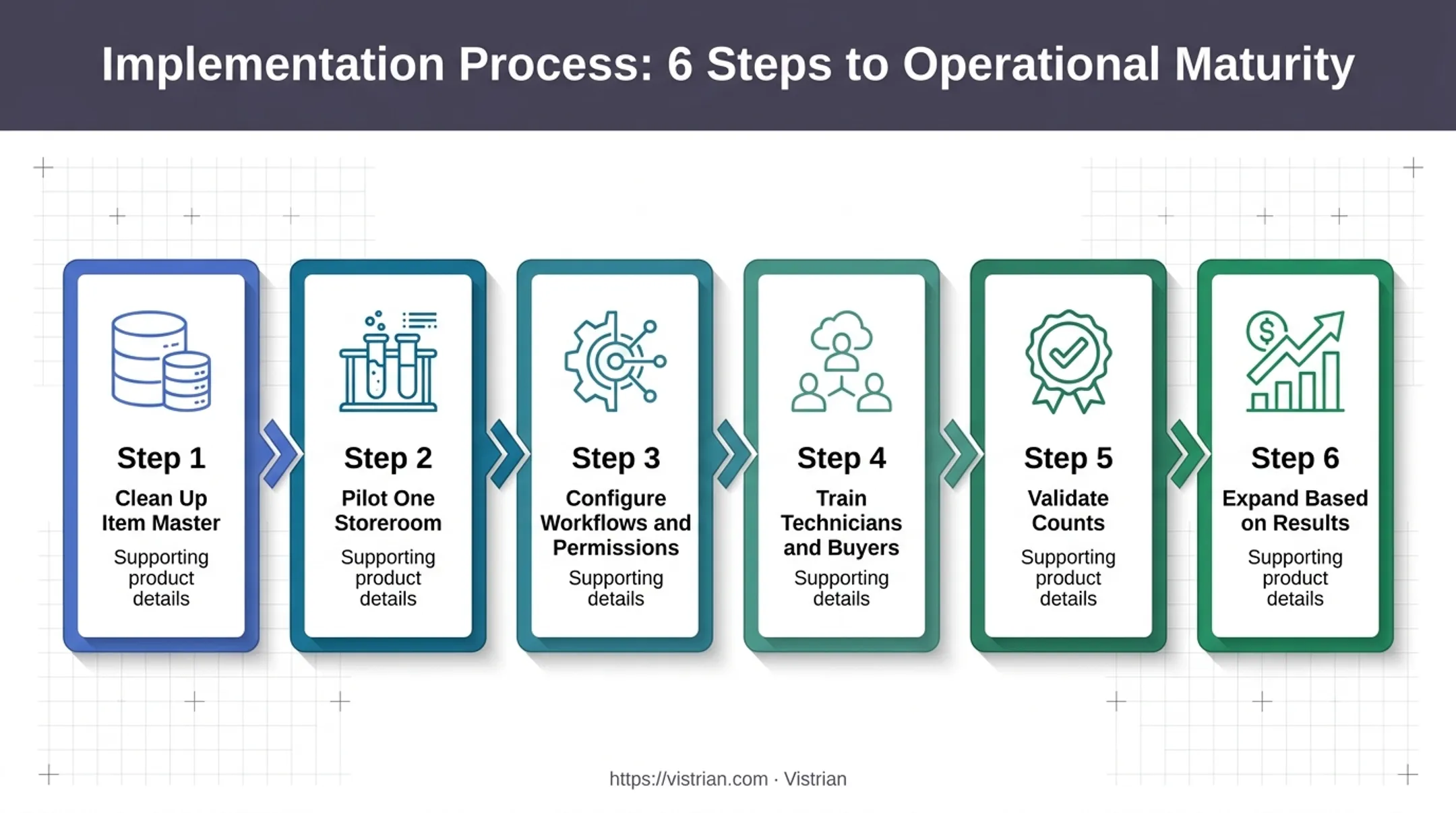

Implementation Sequence That Works
- Clean up the item master so every SKU has one trusted record
- Pilot one storeroom or asset group before a full rollout
- Configure workflows and permissions around real handoffs
- Train technicians and buyers on the live process
- Validate counts against the pilot and fix gaps early
- Expand based on measured results, not assumptions This sequencing matters. Nestlé USA found that factory-specific SAP data silos were creating spare-parts duplication and limited visibility across its network. After standardizing workflows and integrating an AI-enabled search tool with SAP, the company found parts about 50% faster, with monthly tool adoption exceeding 95%. The lesson isn't the specific tool. Standardized data plus connected systems solves a visibility problem spreadsheets alone couldn't.

Measure and Improve Inventory Performance
None of this matters if you're not tracking whether it's working.
A focused scorecard should cover:
- Inventory-record accuracy
- Stockout frequency
- Emergency purchase rate
- Parts availability for scheduled work
- Inventory value and carrying cost
- Obsolete stock percentage
- Purchase-order cycle time
- Inventory turnover
Read these metrics together, not in isolation. A high availability rate might be masking excessive overstock. Low inventory value might mean dangerous stockouts, not lean efficiency.
On accuracy specifically, the Institute for Supply Management reports an industry average of 91%, with 90% considered good and 95% considered world class. This is useful context, though it's a general supply-management benchmark rather than an MRO-specific one.
Connect these numbers to maintenance outcomes: schedule compliance, mean time to repair, wrench time, and preventive-maintenance completion rates. If PM completion is slipping and parts availability is the bottleneck, that's your inventory system telling you something specific.
Set a regular review cadence where maintenance, storeroom staff, procurement, finance, and operations jointly adjust reorder levels and supplier strategies. Vistrian customers using the Maintenance Suite have reported as much as a 17.8% reduction in MRO inventory and a 20.1% reduction in equipment downtime through better visibility into existing stock rather than simply buying more.
Frequently Asked Questions
What does "maintenance inventory" mean?
Maintenance inventory refers to the parts, materials, consumables, tools, and supplies held specifically to maintain, repair, and operate assets. Unlike production inventory, it never becomes part of a shipped product.
What are examples of MRO products?
Common examples include bearings, belts, motors, filters, lubricants, fasteners, electrical components, hand tools, and personal protective equipment. Anything used to keep equipment running rather than sold to customers.
What are the 7 elements of maintenance?
One commonly cited list includes inspection, servicing, calibration, testing, alignment, adjustment, and installation. No single authoritative seven-element standard exists across the industry, so treat this as one useful framework rather than a universal rule.
What are four types of inventory?
A common shorthand splits inventory into raw materials, work-in-process, finished goods, and MRO inventory. Broader frameworks list additional categories, but this four-part breakdown covers most manufacturing operations.
What is the 80/20 rule in inventory?
The 80/20 rule, based on the Pareto principle, suggests roughly 80% of your inventory value or impact comes from about 20% of your items. Validate the actual ratio against your own usage and criticality data rather than assuming it applies exactly.
